Columbia Pike Transportation Update
Columbia Pike Summer 2025: By the Block

Having trouble viewing this email? View it as a Web page.

Transportation Header

Columbia Pike Transportation Update

August 27, 2025

Visit the My Arlington map to learn about other projects in your area

Columbia Pike Summer 2025: By the Block

This week, project staff from the Columbia Pike Multimodal Improvements project presented at the Business Roundtable hosted by Columbia Pike Partnership, and covered some of the recent and current activity on Columbia Pike and adjoining roads within the project area.

We'd like to share the same graphics with you to pull the curtain back on some of the work and to understand what crews have been up to this summer, as well as what they're working on, and what remains.

The project is still on track for substantial completion at the end of 2025, with some small items to be completed in early 2026. For more information, visit ColumbiaPikeForward.com.

Work Completed This Summer

From S. Walter Reed Dr. to S. Cleveland St.

1. Asphalt restoration on S. Walter Reed Dr. north and south of Columbia Pike is complete

2. Traffic signal foundations have been poured at the southeast and southwest corners of S. Walter Reed Dr. and Columbia Pike

3. All base and immediate asphalt on Columbia Pike is complete

4. Asphalt reconstruction on S. Cleveland St. is complete

4. Concrete island between S. Cleveland St. and S. Barton St. is complete

CPP RT - SWRD-CLEVELAND - 082025

From S. Barton St. to S. Wayne St.

1. Traffic signal foundations have been poured at the southeast and southwest corners of the S. Barton St. intersection

2. Base and intermediate asphalt work is complete on Columbia Pike between S. Barton St. and S. Wayne St.

3. Traffic signal foundations have been poured at S. Wayne St.

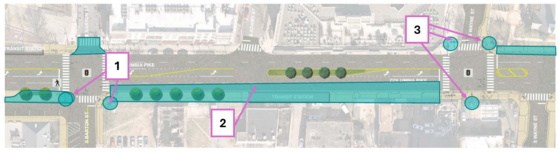

CPP RT - BARTON-WAYNE - 082025

From S. Wayne St. to S. Courthouse Rd.

1.The sidewalk on the north side of Columbia Pike between South Courthouse Road and South Wayne Street are complete and opened.

2. The sidewalk was widened to make room for people walking and people at the future transit station. In the roadway, a concrete pad in front of the bus stop will provide a more durable spot for buses to pause and serve passengers.

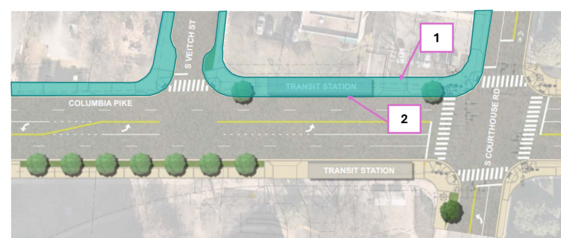

CPP RT - WAYNE TO COURTHOUSE - 082025

From S. Courthouse Rd. to S. Scott St.

1. Base and intermediate paving in outer lanes and driveway construction are complete in both directions

2. South sidewalk complete between South Courthouse Road and South Scott Street

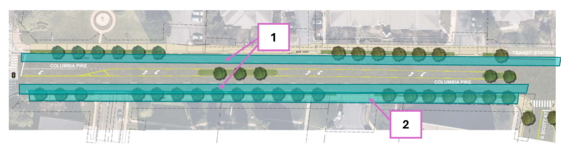

CPP RT - Courthouse to Scott - 082025

From S. Scott St. to S. Rolfe St.

Concrete driveway aprons have been installed on the south side between S. Scott St. and S. Rolfe St.

CPP RT - Scott to Quinn - 082025

So What's Going on Now, and What's Next?

Crews are actively working on tasks in Segment D and Segment C, with some upcoming work throughout the corridor.

From S. Walter Reed Dr. to S. Edgewood St.

1. Upcoming installation of signal pole foundations at north side of S. Walter Reed Dr. intersection

2. Concrete for sidewalk between S. Edgewood St. and S. Cleveland St. expected in September

CPP RT - SWRD to Cleveland - August 2025

From S. Cleveland St. to S. Barton St.

1. Upcoming pouring traffic signal foundations at northwest and northeast corner of S. Barton St.

2. Upcoming asphalt and sidewalk reconstruction on the access road in front of Arlington Village shopping center. The parking lot in the rear of the building will remain open, as will the sidewalk in front of the shopping center.

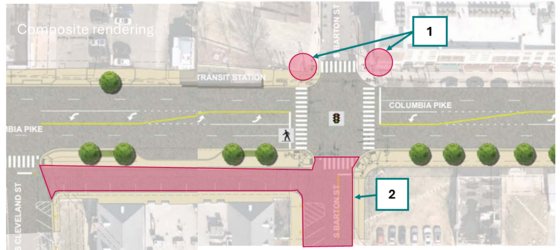

CPP RT - Cleveland to Barton to do - Aug 2025

From S. Courthouse Rd. to S. Scott St.

1. Transformer relocation at the southwestern corner of S. Courthouse Rd. expected in September

2. Grading and asphalt reconstruction in progress

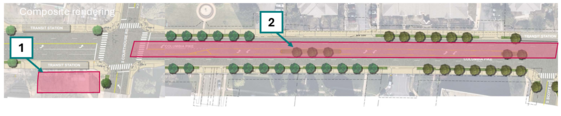

CPP RT - Courthouse to Scott to do - Aug 2025

From S. Scott St. to S. Quinn St.

1. Pedestrian signal foundations, push buttons and conduit installation in progress at S. Scott St.

2. Eastbound right hand lane asphalt reconstruction in progress between S. Scott St. and S. Rolfe St.

3. Traffic signal foundations and conduit installation in progress at S. Rolfe St.

4. Ongoing retaining wall construction between S. Rolfe St. and S. Quinn St. on the south side, to be followed by sidewalk reconstruction

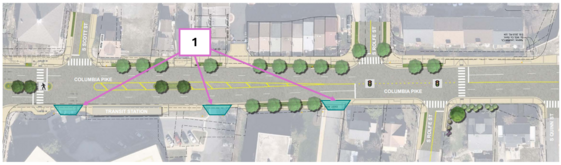

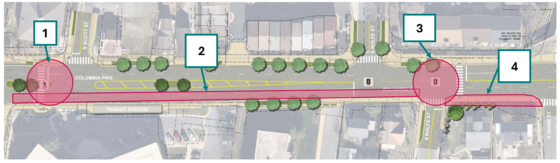

CPP RT - Scott to Quinn to do - Aug 2025
